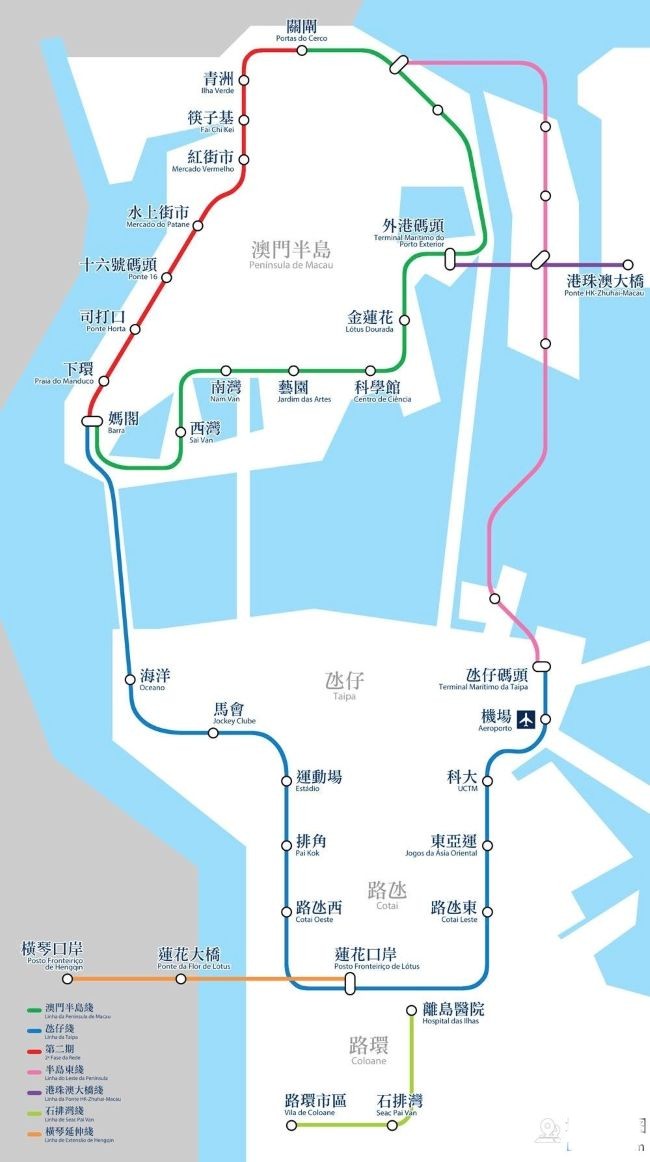

Macau Light Rail East Line: Latest progress update

The Macau Light Rail East Line is a strategic infrastructure project designed to enhance connectivity between the Macau Peninsula and Taipa. The project is progressing steadily, with key milestones already achieved.


Construction Progress
Civil Works Initiation: Construction officially commenced in Q3 2023. The line is divided into northern and southern segments, comprising:
- 6 underground stations
- Shield tunnels
- Cut-and-cover tunnels
- Elevated bridge structures

Completion Status: As of now, approximately 41% of the total works have been completed, with several milestones ahead of schedule.

Tunnel Boring Machines (TBMs):
Northern segment TBM launched on May 7
Southern segment TBM launched on May 28

Station Adjustment: ES1 Station has been shifted approximately 80 meters westward toward the Gongbei Port to improve intermodal connectivity, following approval for use of a V-shaped site.

Timeline for Operation
- Civil Works Completion: Expected by Q1 2028
- Operational Readiness: Targeted for the second half of 2029

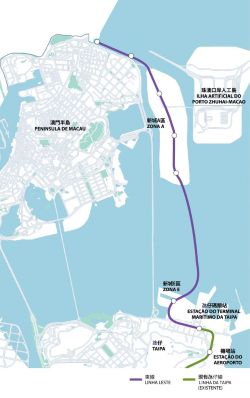

The East Line spans approximately 7.7 km and includes six underground stations, with the cross-sea connection via a 12.1-meter diameter shield tunnel.

The total development cost for the Macau Light Rail East Line is MOP 9.28 billion (approximately US$1.16 billion). This figure is based on two separate construction tenders for the northern and southern sections of the line.

Total project cost: MOP 9.28 billion
Cost breakdown:
The total cost is divided between two separate construction tenders:
Northern section: MOP 4.47 billion
Southern section: MOP 4.81 billion
